The modular home setup workflow is a coordinated, multi-stage process covering site preparation, factory module construction, crane installation, structural anchoring, and energy system integration. Industry data shows the complete build process typically takes 4 to 8 months, with factory construction alone running 6 to 12 weeks. Getting each stage right, in the right order, is what separates a smooth installation from an expensive, delay-ridden one. This guide walks you through every step of the prefab home setup process, including how to integrate solar panels and battery storage from day one.

What are the prerequisites and site preparation steps for modular home setup?

Site preparation is the foundation of the entire modular home installation process, and skipping steps here creates problems that compound at every stage that follows. Before a single module leaves the factory, your land must be assessed, permitted, and physically ready to receive it.

Start with a thorough site assessment. You need to confirm that the land is accessible for large delivery lorries and a crane, that the soil can support the weight of the equipment, and that there are no underground utilities or drainage issues that could delay groundwork. A site that looks flat from the road can still have drainage gradients or soft ground that requires remediation before any foundation work begins.

Site assessor inspecting modular home delivery access

Permits and approvals come next. Municipal planning permission, building regulations approval, and utility connection agreements all need to be in place before construction starts. Utility providers in particular require significant lead time. Utility prep can add up to three or more weeks to your schedule depending on local inspection queues and provider availability. Contacting your electricity network operator and water authority at the earliest possible stage is not optional. It is the difference between a smooth set day and a costly stand-down.

Once permits are secured, site clearing and grading can begin. This involves removing trees, vegetation, and debris, levelling the ground, and installing drainage where needed. Foundation construction follows, and the type you choose matters. Modular homes are compatible with concrete slab, crawl space, and full basement foundations, each with different cost and timeline implications.

The crane setup area deserves particular attention. A 100-tonne crane requires a 30 by 40 foot area of flat, highly compacted ground, plus 45 to 60 minutes for machine setup before any lifting begins. If your site cannot accommodate this, you will need to plan for a smaller crane configuration or additional groundwork.

  • Confirm road access width and weight limits for delivery lorries
  • Obtain planning permission and building regulations approval before breaking ground
  • Contact utility providers at least 6 to 8 weeks before your target set date
  • Prepare a flat, compacted crane pad of at least 30 by 40 feet
  • Install utility trenches and temporary shutoffs before foundation pour
  • Check for overhead power lines and arrange deactivation well in advance
  • Confirm foundation type and have it inspected before module delivery

Pro Tip: Book your crane and confirm your set date before finalising your foundation pour schedule. Crane availability in rural areas can be limited, and your foundation needs to cure fully before modules are placed.

How does factory module construction fit into the overall modular home installation process?

One of the most significant advantages of modular construction is that factory work and site preparation run simultaneously. Parallel workflows between factory module construction and foundation work compress overall build times and reduce delays. This is the core efficiency argument for modular over traditional stick-built construction.

Here is what happens inside the factory during your site prep phase:

  1. Structural framing is completed using precision jigs that ensure every module meets dimensional tolerances tighter than typical on-site builds.
  2. Insulation installation takes place in controlled conditions, eliminating the moisture and weather exposure that can compromise insulation performance in traditional builds.
  3. Electrical, plumbing, and HVAC rough-ins are completed and inspected before the module leaves the factory. Connection points are pre-positioned to align with your site’s utility trenches.
  4. Interior finishes including flooring, cabinetry, and wall finishes are installed and protected for transport.
  5. Quality control inspections are carried out against CSA-A277 standards (the recognised industry standard for factory-built housing), covering structural, mechanical, and energy performance criteria.
  6. Module preparation for transport includes temporary bracing, weatherproofing wraps, and securing of all loose components.

The coordination challenge is aligning module completion with site readiness. If your foundation is delayed by weather or inspection backlogs, you may face storage costs at the factory. If the factory runs ahead of schedule and your site is not ready, modules may need to be held or rerouted. Maintaining weekly communication with both your site contractor and the factory production team is the practical way to keep these two tracks synchronised.

Factory delays, though less common than site delays, do happen. Material supply issues or production scheduling conflicts can push completion by one to three weeks. Build this buffer into your overall project timeline from the start.

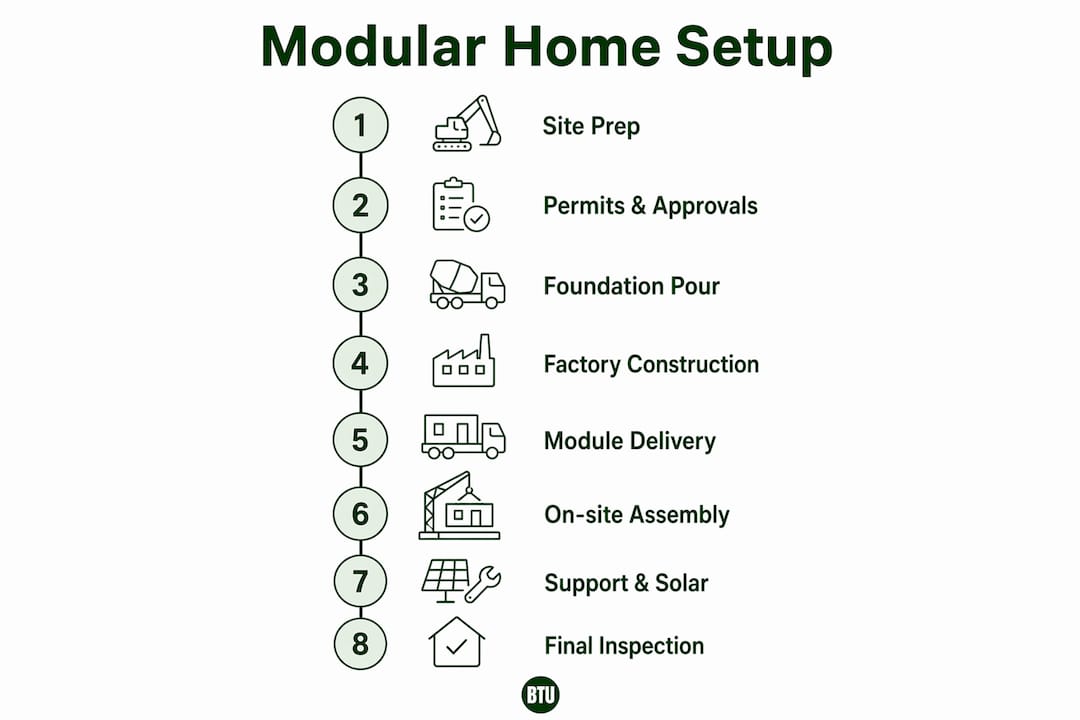

Infographic depicting modular home setup workflow steps

What does the on-site modular home assembly and crane installation day entail?

Set day is the most visible and time-critical stage of the entire prefab home setup. Module delivery, unloading, and sequential lifting follow a precise timeline to ensure proper alignment and weatherproofing. A well-run set day on a two-module home can be completed in a single day. A poorly planned one can stretch across multiple days at significant additional cost.

Here is how a typical set day unfolds:

  • Crane arrival and setup (early morning): The crane operator arrives first, assesses the pad, extends outriggers, levels the machine, and installs counterweights. This takes 45 to 60 minutes and cannot be rushed.
  • Module delivery sequence: Lorries arrive in the order modules will be placed. The sequence matters because once a module is set, it cannot be easily repositioned.
  • Lifting and placement: Each module is rigged, lifted, and guided onto the foundation by the crane operator and a ground crew. Precision here is non-negotiable.
  • Marriage line formation: Where two modules meet, the marriage line must be aligned, bolted, and sealed to create an airtight, weathertight joint. This affects both structural integrity and thermal performance.
  • Upper floors and roof elements: On multi-storey homes, upper modules are placed after lower ones are secured. Roof panels or ridge beams may be lifted separately.
  • Initial weatherproofing: Roof seams and exterior joints are sealed before the crew leaves site, even if interior finishing work continues over following weeks.
Stage Typical duration Key risk
Crane setup 45 to 60 minutes Soft or uneven pad
Module delivery and rigging 30 to 60 minutes per module Lorry sequencing errors
Placement and alignment 1 to 2 hours per module Foundation level tolerance
Marriage line sealing 2 to 4 hours Weather, wind speed
Roof weatherproofing 1 to 3 hours Rain or high winds

Safety regulations require 10 to 20 feet clearance from power lines during crane operation, depending on voltage. If overhead lines have not been deactivated in advance, the crane operator will not lift. This is a non-negotiable safety rule, and it is one of the most common causes of set day stand-downs.

Pro Tip: Stage your modules off-site on a nearby flat area if your plot is wooded or has restricted access. Shuttle delivery adds time but prevents the crane from sitting idle while lorries manoeuvre on a tight site.

“The crane operator has final authority over all safety and timing decisions on set day, including weather-based lift cancellations. Respect that authority. It protects your modules, your crew, and your project.”

How to install the support system, anchoring, and integrate solar panels

Professional installation of support systems is critical because anchoring and levelling directly influence long-term structural integrity and energy efficiency. A module that is not level will rack over time, causing doors and windows to bind, seals to fail, and thermal bridging to develop at joints.

Foundation levelling must be accurate to within 1/4 inch tolerance across the full footprint. Any deviation beyond this requires shim work after placement, which is time-consuming and, if done poorly, creates uneven load paths. Have your foundation checked by a surveyor before set day, not after.

Anchoring for wind resistance is equally important. Tie-down systems connect the module frame to the foundation using engineered steel straps or bolted brackets. The specification depends on your local wind zone and the structural engineer’s design. Do not substitute or skip components in the anchoring system.

Solar integration is most cost-effective when planned during the setup workflow rather than retrofitted later. Here is how to approach it:

  • Pre-wire during factory build: Ask the factory to install conduit runs and junction boxes for solar wiring before modules leave the production line. This saves significant labour cost on site.
  • Roof orientation and pitch: Confirm your module roof orientation during design. South-facing roofs at 30 to 40 degrees pitch deliver the best solar yield in the UK and northern Europe.
  • Battery storage location: Designate a utility room or garage space for battery storage during the floor plan stage. Retrofitting a battery enclosure is far more disruptive than planning for it from the start.
  • DNO notification: In the UK, connecting a solar system above 3.68kW to the grid requires notification to your Distribution Network Operator. Factor this into your utility coordination timeline.
  • Inverter placement: Locate your inverter close to the consumer unit to minimise cable runs and voltage drop.

Understanding prefab home energy performance before you finalise your energy system design will help you size solar and storage correctly for your actual consumption patterns.

What are the best practices to optimise your modular home assembly workflow?

Avoiding delays in a modular build comes down to one principle: every stage depends on the one before it, so any slip compounds forward. The steps below address the most common failure points.

  1. Create a master schedule that maps factory build milestones, site prep stages, permit approval windows, and utility provider lead times onto a single timeline. Share it with every contractor involved.
  2. Book crane hire early. In rural areas, specialist crane operators with modular home experience may have lead times of four to six weeks. Booking late is one of the most avoidable causes of set day delays.
  3. Confirm foundation level tolerance with a surveyor at least one week before set day. Discovering a level issue on the morning of the crane lift is expensive and stressful.
  4. Coordinate utility disconnections at least six weeks in advance. Failing to coordinate utility disconnections weeks ahead often causes mandatory crane lift delays with immediate stand-downs that raise project costs.
  5. Plan for weather contingencies. Have a rescheduling plan agreed with your crane operator and factory before set day. Wind speeds above a certain threshold will ground the lift regardless of schedule pressure.
  6. Conduct energy performance checks post-install. Test airtightness at the marriage line, check insulation continuity at module joints, and verify solar wiring connections before commissioning the system.
  7. Schedule final inspections early. Delays in utility scheduling and inspection can significantly prolong move-in readiness. Book your building control sign-off and utility connection inspections as soon as set day is confirmed.

If you are considering retrofitting energy solutions after move-in, be aware that post-installation solar wiring is considerably more disruptive and costly than integrating it during the original setup workflow.

Key takeaways

A well-executed modular home setup workflow requires parallel planning of factory construction and site preparation, precise crane logistics, and early integration of solar and battery systems to deliver a structurally sound, energy-efficient home on time.

Point Details
Site prep is the critical path Permits, utility coordination, and crane pad preparation must begin weeks before set day.
Factory and site work run in parallel Synchronising these two tracks is the primary driver of overall build speed.
Set day precision determines quality Foundation level tolerance, marriage line sealing, and crane safety clearances are non-negotiable.
Solar integration is cheapest at build stage Pre-wiring during factory construction saves significant labour cost compared to retrofitting.
Utility coordination drives move-in date Electrical hookups and final inspections must be booked early to avoid weeks of unnecessary delay.

Why I think most modular home projects lose time in the same two places

Having worked across property development and renewable energy commissioning, the pattern I see most often is this: people plan the visible stages well and underestimate the invisible ones. The crane arrives on time. The modules look perfect. And then the project stalls for three weeks because nobody called the electricity network operator early enough, or because the foundation is two centimetres out of tolerance and the shim work takes four days.

The second place projects lose time is solar integration. Most people treat it as a finishing touch rather than a structural decision. By the time they think about where the inverter goes or how the battery will be wired, the walls are closed and the roof is sealed. What should have been a half-day factory task becomes a week of remedial work on site.

My honest recommendation: treat your utility coordination and your energy system design with the same urgency you give to the crane booking. They are equally time-critical, and they are far easier to get right at the planning stage than to fix later. If you are serious about energy-efficient prefab living, the decisions you make during the setup workflow will shape your energy bills and comfort for decades.

Power your modular home with solar from day one

Getting your modular home set up efficiently is only part of the picture. The energy system you install during the setup workflow will determine your running costs and energy independence for years to come. Solar panels and battery storage are the most practical way to reduce grid dependence, and integrating them during the build stage costs significantly less than retrofitting later.

At Beyondtheurban, we cover everything you need to understand about solar panels and battery storage for residential properties, from sizing your system correctly to understanding UK grid connection rules and the Smart Export Guarantee. If you want to know how solar can add value to your property, our guide on solar panels and home value is a practical starting point. Explore the Beyondtheurban Solar Hub to find clear, jargon-free guidance built for UK and European homeowners.

FAQ

How long does a modular home setup take from start to finish?

The complete process typically takes 4 to 8 months, with factory construction running 6 to 12 weeks and on-site work including permits and foundation taking 1 to 3 months.

What foundation types work best for modular homes?

Modular homes are compatible with concrete slab, crawl space, and full basement foundations. The choice depends on your site conditions, local building regulations, and budget.

When is the best time to integrate solar panels into a modular home?

Solar integration is most cost-effective during the factory build stage, when conduit runs and junction boxes can be pre-installed before modules leave production. Retrofitting after move-in is significantly more expensive.

What causes most set day delays on modular home projects?

The most common causes are unprepared crane pads, overhead power lines that have not been deactivated, and foundations that fall outside the required 1/4 inch level tolerance. All three are preventable with early planning.

Do I need to notify my DNO before connecting solar to a modular home?

In the UK, any solar system above 3.68kW connected to the grid requires prior notification to your Distribution Network Operator. This should be factored into your utility coordination timeline during the setup workflow.

Thomas Gauci

I’m Thomas Gauci, a commissioning engineer and property developer with over a decade of experience in project management, sustainable living, and renewable energy solutions. Beyond the Urban was born out of a simple yet powerful idea: to make sustainable, independent living accessible and attainable for everyone.
